Projects

Members and milestones

Updated in 5.20.93

This is the project's own page. Members are the people who work on the project. Milestones are the points it must reach, each with a due date.

Where

Projects & Tasks › Projects › a project · More › Members · Work › Milestones

Who

The project's manager, or anyone allowed to edit projects.

The page's buttons and tabs are described in Start a project.

On the Projects list, pressing a project's name opens a quick look at it first: its progress, its open tasks and its latest task. Press Open full page to reach the project's own page.

The quick look at a project, with Open full page at its foot

Members

1
Press More and then Members, or press + beside the faces in the head of the page.
2
Choose the people and press Save.

The Members box of a project
Membership decides what a person can see. Adding a person gives them this project, its tasks and its sprints. Removing a person takes all of that away.

A first task for the new member

1
On the project's page press + New task and type the Task name.
2
In Assignees, choose the new member.
3
Flowrica looks at similar finished tasks on her own and says how long they took, for example “Similar tasks took about 7 h”. Press Use this estimate and the hours are filled in for you, or leave it.
4
Press Create the task. Under Work the task is in the new member's name.
The New task form: Flowrica's estimate from similar tasks, with Use this estimate

Milestones

1
Press Work, then Milestones, then + New milestone.

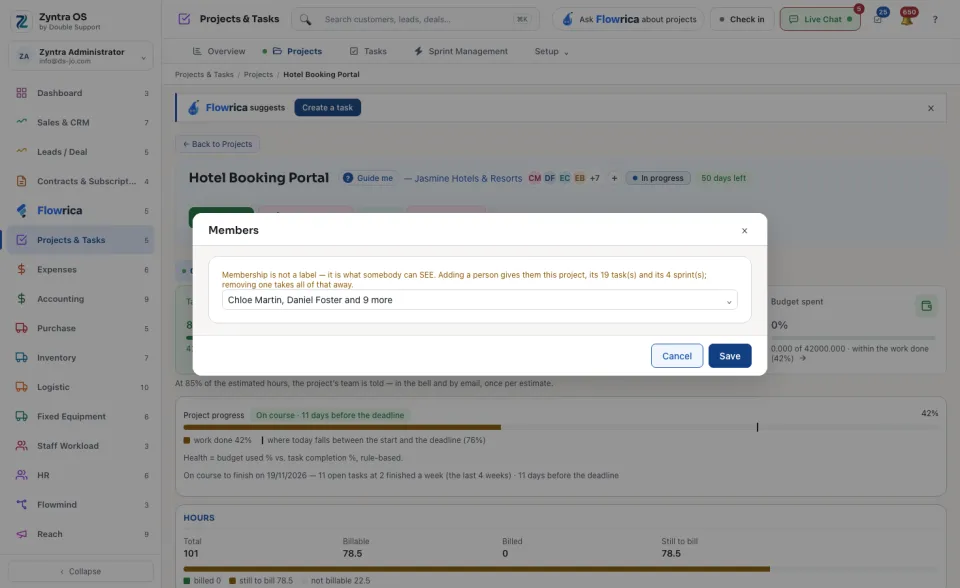

A project's milestones
2
Type the Milestone name and choose its Due date. Both are needed. You can add a Start date, a Colour and a Description.
3
Tick Hide this milestone from the customer if the client portal should not show it, or Show its description to the customer if the customer should read the description too.
4
Press Save.

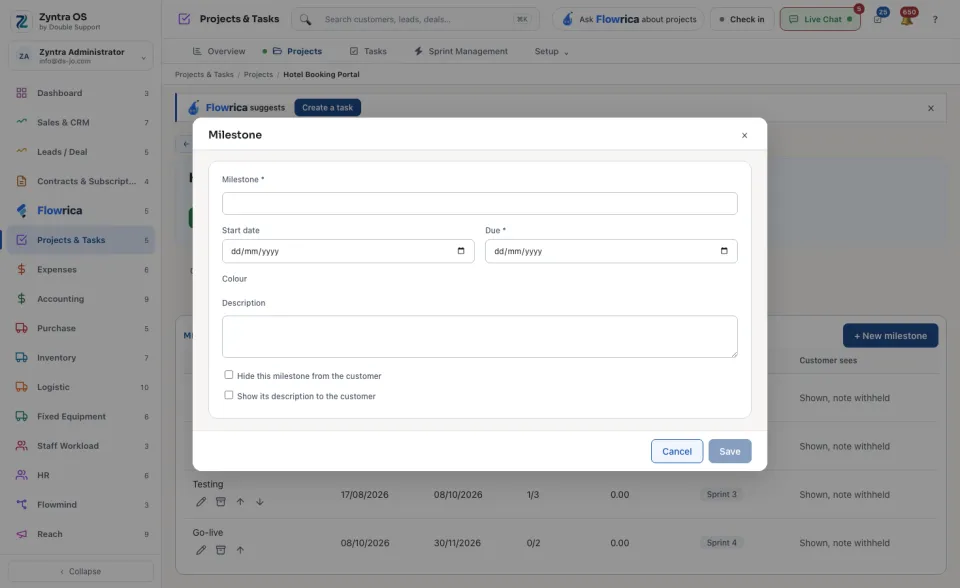

The Milestone form

A task is put under a milestone from the task's own form: the Milestone field appears once the task has a project.

To put a task under a milestone: open the task, press Open full page, then Edit, choose the milestone in the Milestone field and press Save.

The Milestones table shows each milestone with its dates, Tasks done (for example 0/1), Logged time, Linked sprints and what the Customer sees. Both counts fill by themselves: each finished task raises its milestone's count and adds its logged time.

The Milestones table: Tasks done, Logged time, Linked sprints and Customer sees

Each row has its own icons. Move up and Move down change the milestone's place in the list. Archive takes a milestone that is no longer needed out of the plan: its tasks stay in the project and go back to no milestone.

A late task that holds back a payment

When an invoice payment is billed when a milestone is done, a late task under that milestone carries Flowrica's note on its page, for example “This task holds back 6,000, billed when Installation and cabling is done.” She says it by herself. Once the task is Complete, the milestone's count goes up by itself and the payment is closer to being billed.

A late task: Flowrica says which payment it holds back

Change the project's status

Press More and then Mark as…. Choose the Status and press Save. You can tick the box that also completes the project's open tasks.

Flowrica on this page

Press Ask Flowrica in the head to ask about this project, for example “What is this project's story?”. ✨ Client report drafts a report for the customer. Press Guide me and she points at each part of the page.

Why is a project late?

A project past its deadline carries a red badge in its head, for example Late by 7 days, and Flowrica's note under it: “… passed its deadline on … and is not closed.”

A late project: the red Late by 7 days badge and Flowrica's note
1
Press Ask Flowrica and choose “What is this project's story?”. Flowrica answers in four parts: Where it stands (its status and deadline), Who it is for, What is still open (the first task due and how many are overdue) and The last thing that happened.
What is this project's story: where it stands, who it is for, what is still open, the last thing that happened
2
Ask “Why is this project late?”. Flowrica says how many days it is past the deadline, names the late tasks with their due dates and who has them, and points at a task waiting on another and a task with nobody on it. You know why in seconds, without opening every task.
Why is this project late: the late tasks, their due dates and who has them
